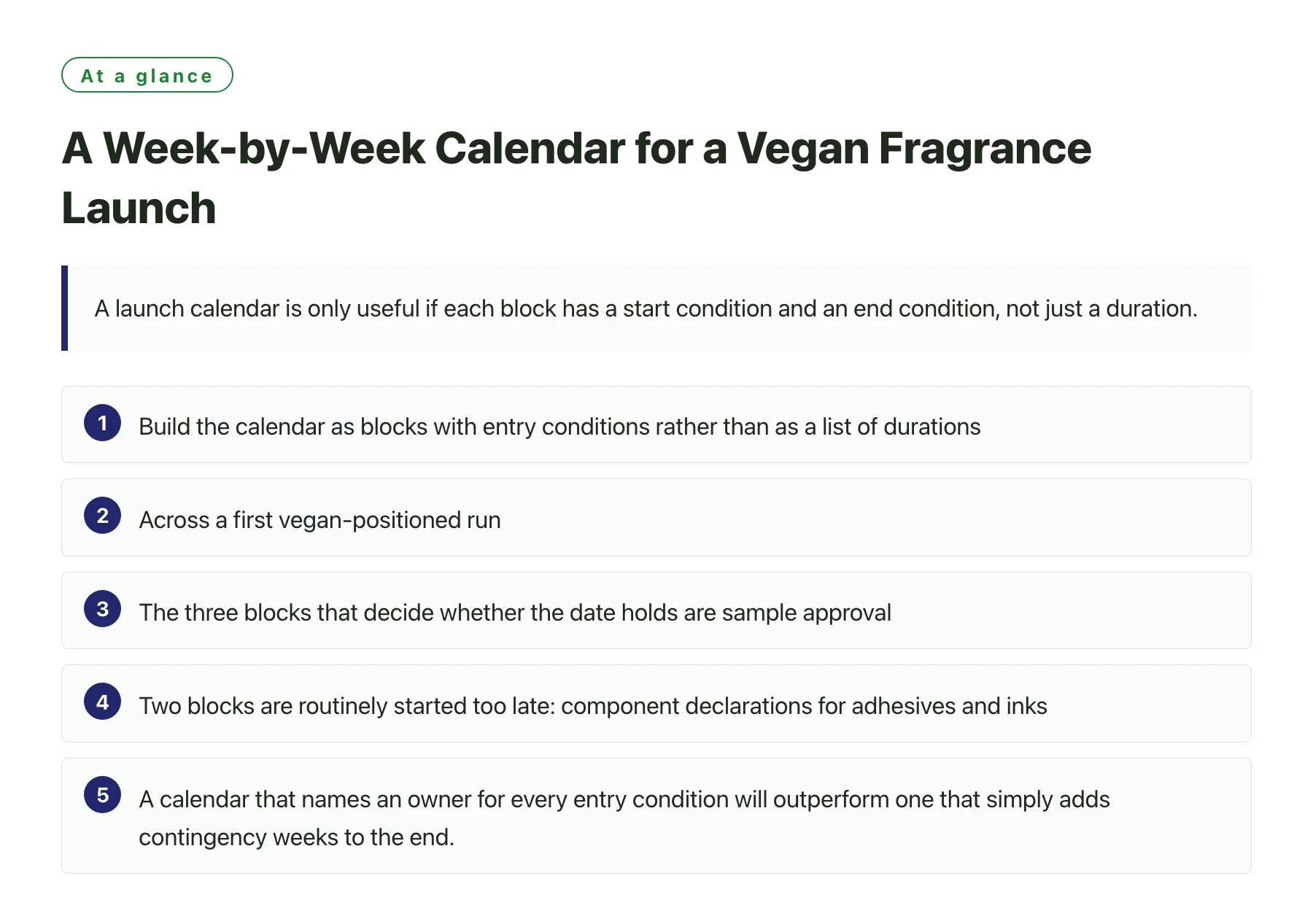

A launch calendar is only useful if each block has a start condition and an end condition, not just a duration. Written that way, a first vegan-positioned fragrance run takes roughly five to six months from signed brief to shipped pallet, and most of the risk sits in three blocks: sample approval, material documentation and label review. The production block itself is short and predictable. If your calendar shows the opposite, it is describing a project that will move.
Key takeaways
- Build the calendar as blocks with entry conditions rather than as a list of durations, because conditions are what actually gate progress.
- Across a first vegan-positioned run, five to six months from signed brief to shipped goods is a workable planning assumption with normal revision rounds included.
- The three blocks that decide whether the date holds are sample approval, material documentation and label review; everything after tooling is comparatively stable.
- Two blocks are routinely started too late: component declarations for adhesives and inks, and the label review for each destination market.
- A calendar that names an owner for every entry condition will outperform one that simply adds contingency weeks to the end.
Project managers tend to inherit calendars that look like bar charts in a slide and behave like wish lists in practice. The difference between the two is whether each block states what has to be true before it can begin. A block labelled "sampling, three weeks" is a wish. A block that says sampling starts when the brief is signed and the reference set is agreed is a plan, because it tells you what to chase when the date slips.
This calendar is written for a brand running its first vegan-positioned fragrance product through an external manufacturer, with one or two scents and one or two destination markets. It assumes the brand has decided the claim, the format and the price ceiling. It does not assume the brand has any documentation process in place, because most do not.
Treat the blocks as the structure and the durations as defaults. Change the durations to match the factory you are actually using; keep the conditions, because they are the part that transfers between suppliers.
How to read the calendar
Each block below has a doorway and an exit. The doorway is the condition that has to be met for the block to start at all, and the exit is the artefact that proves it finished. When a project slips, the useful diagnostic is almost never "which block ran long" but "which exit was missing", because a missing artefact propagates into every block that depends on it.
Two blocks run in parallel with the visible work: documentation and label review. Neither appears in a simple gantt chart drawn by someone who thinks of a fragrance project as design followed by production, and both sit on the critical path for a positioned product.
The market framework is one of the things worth settling before the clock starts, because destination markets determine which labelling questions have to be answered. The European Commission maintains an overview of how cosmetics are regulated and sold in the European Union, which is a reasonable orientation point for the market question [1]. Trade press such as Cosmetics Business is useful for a lighter read on how the sector is moving, but it does not substitute for the rules of the market you are entering [2].
Where the museum visit fits, if you plan one
Some brands schedule a structured scent session early, to widen the team's reference vocabulary before the brief is written. That block belongs before sampling rather than after, and it is optional. If the team cannot describe what it wants in a way a perfumer can act on, an afternoon of guided comparison is cheaper than a wasted sample round; a museum built around smell is the kind of venue that supports that work.
The eight blocks
- Block 1: Claim, market and format — weeks 1 to 2Entry: a decision-maker is available. Exit: the exact claim wording, the destination markets, the fill size, the concentration and a target cost that the retail price can carry. Nothing else starts until this is written down.
- Block 2: Brief and supplier confirmation — weeks 2 to 4Entry: Block 1 exits. Exit: a signed brief with three references, the constraints list, volume scenarios and a named approval owner on the brand side.
- Block 3: First sample round — weeks 4 to 8Entry: signed brief. Exit: sample set received with its formula specification, evaluated on skin over several hours rather than on blotters in a meeting.
- Block 4: Revision round — weeks 8 to 12Entry: consolidated written feedback. Exit: an approved reference sample, retained by both sides, plus the frozen formula. Documentation collection should already be running inside this block.
- Block 5: Material and component documentation — weeks 6 to 13, parallelEntry: draft formula available. Exit: material statements for the claim, allergen information, and declarations from packaging and decoration suppliers covering adhesives, inks and coatings.
- Block 6: Packaging and label review — weeks 12 to 18Entry: frozen formula and documentation complete. Exit: approved artwork per market, with one correction round still available. This is the block that most often collides with printing.
- Block 7: Production — weeks 18 to 22Entry: components in the warehouse, artwork released, quality plan agreed. Exit: bulk produced against the retained reference sample, with batch records.
- Block 8: Release, inspection and freight — weeks 22 to 26Entry: bulk passed release. Exit: certificate of analysis, shipping documents and the compliance index handed over with the goods.
Where these blocks actually move
Block 4 is the most common overrun, and the reason is rarely the perfumer. It is usually feedback arriving in pieces over two weeks, so a revision that should take ten days takes eighteen. Consolidating feedback into one written response is the single most effective calendar control a brand has.
Block 5 is the most commonly forgotten. If documentation begins when the sample is approved, it runs into Block 6 and Block 7 and pushes printing. Starting it when a draft formula exists costs nothing and removes the collision entirely.
Block 6 is where a positioned product differs most from an unpositioned one, because the label has to satisfy the claim as well as the regulation. A brand selling into two markets should plan two review paths rather than one plus a translation.
Block 7 is stable unless components are late, and that is a packaging problem rather than a fragrance problem. If a single supplier handles formulation, filling and packing, the number of handoffs is smaller and there is one fewer place for a date to be lost. That is the main practical argument for working with a single partner from formula to finished bottle, though it is not the only structure that can work.
Block 8 depends on destination and inspection terms. It is the block most often padded, and padding it hides the fact that the real variance lives four blocks earlier.
Two things to do before the clock starts
First, write the compliance index. One line per document, with the block it gates and the name of the person responsible. It takes an hour and it turns Block 5 from a hope into a tracked workstream.
Second, agree the approval rule. Say in writing who can approve a sample, how many people are consulted, and how long feedback will take. A project that loses three weeks to a slow internal decision will usually blame the factory, which makes the next negotiation harder and the next launch no faster.
Brands that want a structured view of the whole sequence before they draw their own calendar will find one set out on Xuelei Perfumes, covering development, production and the categories the factory works in, which is enough to compare against the blocks above.
Put the documentation block on the chart even if it has no visible output. A block that is invisible in the plan is the block that consumes the contingency.
Sources
- European Commission: Cosmetics in the EU —— The European Commission's overview of EU cosmetics rules, including the responsible person, product information file and safety report requirements.
- Cosmetics Business —— A trade publication covering the beauty and cosmetics industry, including fragrance launches and regulatory developments.
Frequently asked questions
How long does a first vegan perfume launch take?
Five to six months from signed brief to shipped goods is a reasonable planning figure for one or two scents with normal revision rounds, a documentation stage and one destination market. Additional markets add label review time rather than production time.
Which stage of a perfume project most often runs late?
Sample approval, usually because feedback arrives in pieces. Consolidating comments into one written response shortens that block more reliably than asking the factory to work faster.
Should documentation run in parallel with sampling?
Yes. Material statements depend on a draft formula, not an approved one, so the collection can start early. Waiting for approval pushes documentation into the printing stage.
How many months should I add as contingency?
Rather than adding months at the end, add days to the blocks that depend on decisions: sample approval, documentation and label review. Padding production rarely helps, because that stage is the most predictable.
Does the number of destination markets change the calendar?
It changes the label review block, because each market has its own labelling expectations. The fragrance, sampling and production blocks stay the same.
